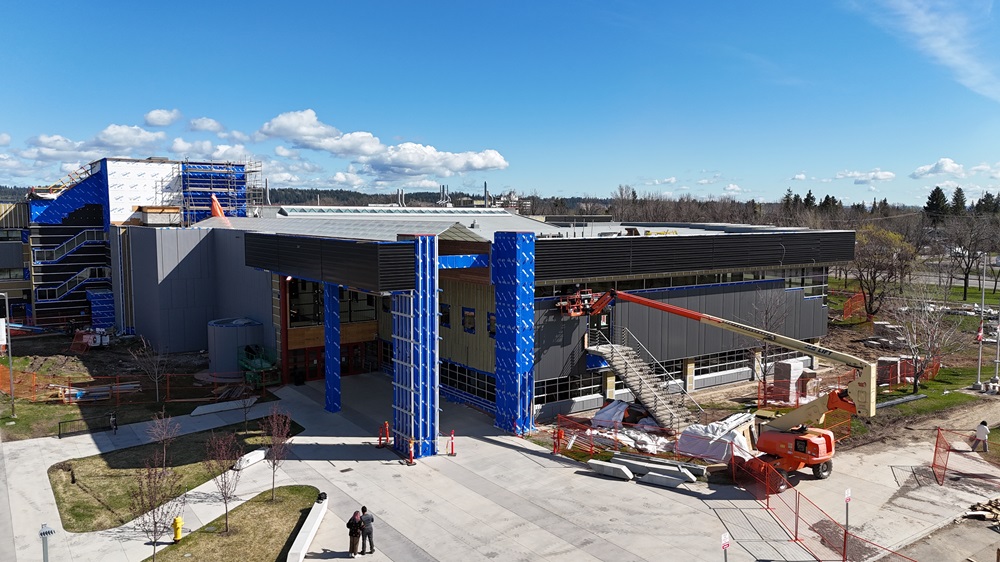

Current Updates
Stay informed with regular updates as construction progresses. We’ll keep you posted on project milestones, potential disruptions, and other important details.
Building envelope upgrades continue across the Prince George Campus throughout June. Current work includes roofing, concrete repairs, glazing, exterior lighting, landscaping, siding installation, weatherproofing, painting, and cleanup activities.
Crews are completing work on entrances, stairwells, canopies, exterior walls, and courtyard areas in the 100, 200, 300, 400, 500, and 700 Blocks. Fence removal and site cleanup will continue as areas are completed.
Accessible parking near the Main Entrance has been relocated until further notice to the crosswalk ramp, and a detour is in place for those walking from the east side.
The East Entrance remains closed, the Main Entrance is partially closed, and the 300 Block 2nd-floor exit to the Trades buildings is closed until June 3rd.
Check the full map to see how campus blocks are connected and where work is taking place.
Expected Impacts:
🔊 Noise: Elevated noise levels from concrete work, stucco removal, roofing activities, metal framing installation, and exterior finishing work.
🚧 Access: Temporary barriers, detours, and intermittent entrance impacts remain in place. The East Entrance remains closed while work continues.
👷Visibility: Construction activity, equipment movement, material staging, landscaping repairs, and cleanup activities continue around active work areas.
Upcoming Activities
June 1 - 7
100 Block
- Prep for landscaping repairs
- Exterior lighting installation
200 Block
- North: Installation of clips and metal framing system 🔊
300 Block
- Stairwell sloped roof repairs above the courtyard 🔊
- Installation of doors, windows, and glazing at the stairwell
- Installation of roof cap flashings 🔊
300 Block South
- Installation of first-floor interior finishes around windows and doors
- Installation of new concrete pads 🔊
- Installation of resized windows
- Installation of siding and wood-look siding finishes
300 Block North
- Installation of clips and metal framing system 🔊
- Slab preparation, rebar installation, and concrete work 🔊
- Crossover bridge resurfacing and repairs 🚧
300 Block West
- Application of waterproof membrane coating
400 Block
500 Block
700 Block
- Pouring new concrete at the East Entrance (entrance closed) 🔊🚧
- Interior cleaning
- Prep for landscaping repairs
- Installation of roof cap flashings 🔊
- Installation of flashing and beauty caps around windows
- Installation of doors and glazing on the east side
- Installation of vestibule doors
- Installation of strip lighting
- Installation of wood-look siding in the main entrance and first floor
- Installation of siding on the mechanical penthouse
- Installation of upper soffits and East Entrance finishes
June 8 - 14
Sitewide
- Fence removal and cleanup activities (100, 300 South, and 700 Blocks) 🚧
- Replacement of damaged sidewalks 🔊
100 Block
- Cleanup of materials and crates
- Landscaping repairs
300 Block South
- Interior finishes continue
- Canopy concrete work 🔊
- Window installation
300 Block North
- Concrete and foundation work continues 🔊
400 Block
- Stucco removal 🔊
- Installation of DensGlass 🔊
700 Block
- East Entrance concrete work continues (entrance closed) 🚧
- Penthouse cleanup
- Landscaping and sprinkler repairs
- Door and glazing installation
June 15 - 21
Sitewide
- Continued fence removal and cleanup 🚧
- Sidewalk replacement work 🔊
300 Block South
- Interior finishes around windows and doors
- Canopy work and exterior finishes
300 Block North
- Concrete and bridge repair work 🔊
400 Block
- Installation of DensGlass🔊
- Installation of framing for strip lighting
500 Block
700 Block
- Replacing vestibule doors
- East side glazing work
- Exterior flashing and siding finishes
- Mechanical penthouse finishes
Safety Reminder
- Please follow all posted signage and detour instructions.
- For your safety, do not enter active construction zones.
June 22 – 28
Sitewide
- Final fence removal and cleanup activities 🚧
300 Block North
- Metal framing and weatherproofing work
300 Block West
- Waterproof membrane and exterior wall work
400 Block
- Exterior panel installation
- Strip lighting framing
700 Block
- Wood-look siding installation
- Soffit and penthouse finishing work
- Final glazing and exterior finishing activities
Project Wide
- Ongoing cleanup, landscaping restoration, and completion work
About the Project
The Building Envelope Project is designed to enhance the exterior of the Prince George campus with energy-efficient upgrades, a modernized aesthetic, and a focus on long-term sustainability. These improvements will provide a more comfortable, energy-efficient space for everyone at CNC while maintaining our facilities’ resilience well into the future.
This project is made possible with restricted capital funding by the Ministry of Infrastructure.
The Building Envelope Project aligns with CNC’s Strategic Plan (lhulh whuts’odutel’eh – Learning Together) under Priority 3.5: Rejuvenate College Infrastructure. Specifically, it supports objectives 3.5.1 through 3.5.4 by upgrading campus infrastructure, revitalizing learning spaces, improving sustainability, and helping reduce the college’s overall carbon footprint.
Key Highlights of the Project:
- Energy-efficient upgrades for better sustainability.
- A modernized campus exterior to reflect our commitment to innovation.
- Long-term durability to ensure the campus remains functional and eco-friendly for years to come.
Project Timeline
- March 2025: Pre-construction preparations and site setup begin.
- April 11: Pre-construction phase
- April 25: Transition to demolition stage.
- May 2025: Official construction begins.
- May 9, 2025: Demolition work on the 100 Block started
- June 8, 2025: 100 Block demolition work largely complete. Demolition work on the 700 Block started.
- June 15, 2025: Demolition work on the east and south side of the 700 Block continues.
- July 2, 2025: Installation of initial building envelope components at the east and south side of the 700 Block started.
- August 11, 2025: Roof work, brick façade and wall stucco removal on the 700 Block started
- August 18, 2025: Penthouse demolition and landscaping work on the 700 Block started
- September 4, 2025: Elevated walkway work on the 300 Block started
- September 8, 2025: Window replacement work on the 100 Block started. Moisture shield barrier installation on 100 Block started.
- October 14, 2025: Sidewalk and foundation removal at the west entrance of the 500 Block for stair replacement started.
- October 20, 2025: 100 Block interior window trims work start. 700 Block brick façade almost done.
- November 25, 2025: 500 block stairs installed. Weight room and 2nd floor open. Slight detour in West Entrance lifted
- November 26, 2025: 700 block, 1st floor window replacement
- December 22, 2025: Water shield installation done
- January 2026:
- Interior and exterior finishing activities continue across active blocks
- Ongoing window replacement and detailing work on the 700 Block
- February 2026:
- Exterior envelope work expands across the 100 and 700 Blocks
- Continued preparation for upcoming roofing, panel, and entrance upgrades
- Interior finishing and staging activities continue in occupied areas
- March 2026:
- Early prep work begins for spring exterior construction activities
- Roofing, panel systems, and exterior access planning continue
- April 2026:
- Major exterior building envelope work ramps up across the 100, 300, 400, and 700 Blocks
- Window sealing, siding installation, roofing, and exterior finishes underway
- May 6-8, 2026: Concrete fin removal above the loading dock
- Duration: Approximately 2 years
- Completion Date: May 2027 (estimated)
Impact on Campus
We are committed to minimizing disruptions during construction. While work is taking place, we will keep staff, students and visitors informed about:
- Campus accessibility
- Potential disruptions
- Changes to parking and entrances
Our team is focused on ensuring that the impact on your daily experience is as minimal as possible.
